Approximately 56.9 km long high standard arterial toll road planned to meet Metro Cebu’s existing and future traffic demand. The project will serve as another north-south backbone highway providing a seamless traffic flow from Naga City up to Danao City traversing along the slopes of the mountain range of Cebu Province and is expected to significantly address the traffic congestion within Metro Cebu especially its urban core and Central Business Districts.

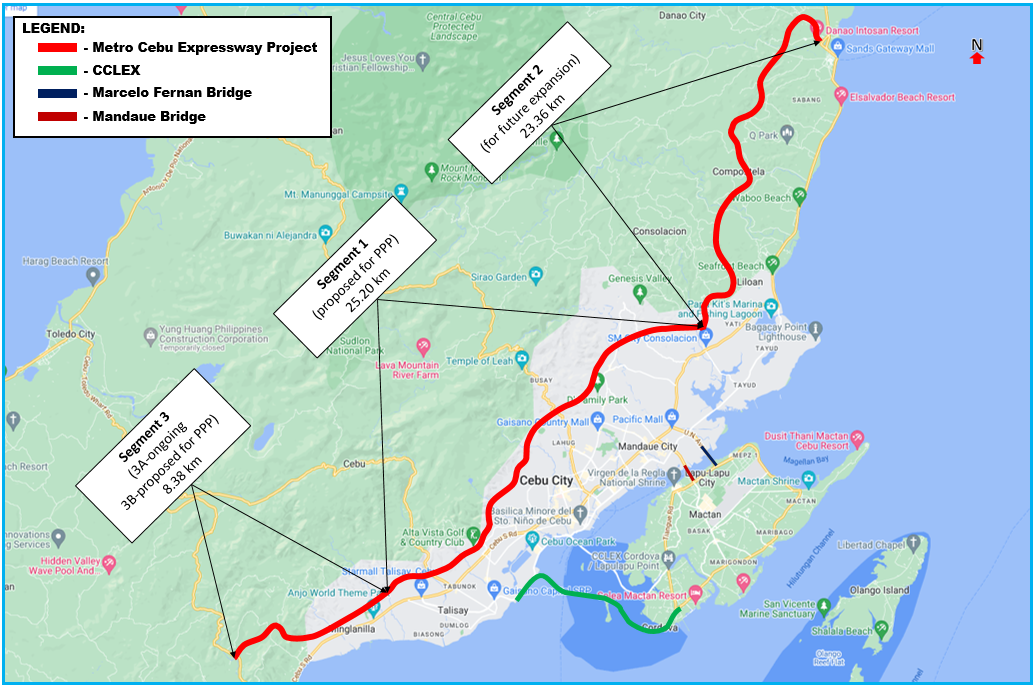

The proposed Metro Cebu Expressway (MCE) project is a South to North bypass road along the hills of Metro Cebu and is divided into three (3) segments. The stationing and the corresponding lengths of each station are shown below:
Segment | Stationing | Length (km) |
1 | Minglanilla – Cebu City – Mandaue/Consolacion Bdry. (Proposed for PPP) | 25.20 |
2 | Mandaue/Consolacion Bdry. to Danao City (For future expansion) | 23.36 |
3A | Naga City – Minglanilla (Ongoing implementation by DPWH Region VII Office) | 4.20 |
3B | Remaining portion proposed for PPP | 4.18 |
| TOTAL | 56.94 |
- Improve and enhance Metro Cebu's seamless east-west, south-north urban inter-modal transport, economic and tourism corridors to meet future transport demand;
- Link Metro Cebu's central, coastal, southern and northern urban districts and economic development with a new upland high standard, high capacity bypass;
- Facilitate the movement of people and commerce from the Central Business Districts [CBDs], economic/export and tourism zones along Metro Cebu's 72-km RIA from south Naga City to north Danao City;
- Contribute in redirecting future urban land-use, demographic and economic expansion by providing transport mobility across urban districts
Segment 1 + Segment 3B
(DPWH & USAID-DELIVER Estimate):
· PHP 52.5 Billion (Civil Works Cost) – 6 lanes
· PHP 18.1 Billion (Right-of-Way Cost)
· PHP 97.07 Billion (Indicative Project Cost)
April 19, 2022 | Presentation to DPWH regular BAC for the procurement of additional consultancy services (EIA, SIA, and RAP). Based on BAC assessment, procurement should be done through PPP PBAC instead. |
Present | Ongoing preparation of bidding documents for additional consultancy services (EIA, SIA, and RAP) to be procured through PPP PBAC. Ongoing preparation for the presentation of DPWH for the second quarter meeting of the Infrastructure Development Committee of Regional Development Council Central Visayas on 27 May 2022. |
SEGMENT 3A (4.2 km) – Ongoing implementation by DPWH Region VII:
Contract ID | Contract Effectivity | Revised Contract Amount (PHP) | Actual Accomp. | Remarks/Status |
18H00046 | July 6, 2018 | 276,396,965.70 | 100% | Project completed on Oct. 19, 2021 |
19H00014 | July 29, 2019 | 264,500,000.00 | 72.83% | Project is suspended |
20H00003 | March 6, 2020 | 193,000,000.00 | 100% | Project completed on Oct. 10, 2021 |
20H00082 | October 5, 2020 | 130,911,000.00 | 88.00% | Project is |
21H00005 | February 22, 2021 | 188,945,000.00 | 63.29% | Project is suspended |
21H00046 | April 5, 2021 | 139,962,234.84 | 35.43% | Project is suspended |
Total | 1,193,715,300.54 | 80.43% |
|
