IMPROVING GROWTH CORRIDORS IN MINDANAO

ROAD SECTOR PROJECT

PROJECT DESCRIPTION:

  • The IGCMRSP under ADB Loan No. 3631-PHI is composed of seven (7) road subprojects with a total length of 228.696 (w/ exceptions) and Guicam Bridge with a length of 540.8 L.M. all located in Zamboanga Peninsula and three (3) bridges of 1,242.2 L.M. located in Tawi-Tawi Province.

PROJECT IMPACT:

  • The project is in line with the strategies of “Accelerating Infrastructure Development of the 2017-2022 Philippine Development Plan (PDP)”, specifically on supporting economic growth and development in Western Mindanao
  • Increase the capacity of the BIMP-EAGA road network
  • Improve and widen existing roads and bridges to upgrade and expand the Philippine road system
  • Improve peace and order situation in Mindanao through road network development

LOAN DETAILS:

  • Signing Date: January 10, 2018
  • Effectivity date: March 23, 2018
  • Closing date: June 30, 2024

COMPONENTS:

Output 1:             Road works improvement in Mindanao

Output 2:             Construction Supervision and Detailed Engineering Design (DED)

Output 3:             Institutional Capacity Development (ICD)

PROJECT COST PhP25.257 Billion (ADB / GOP)

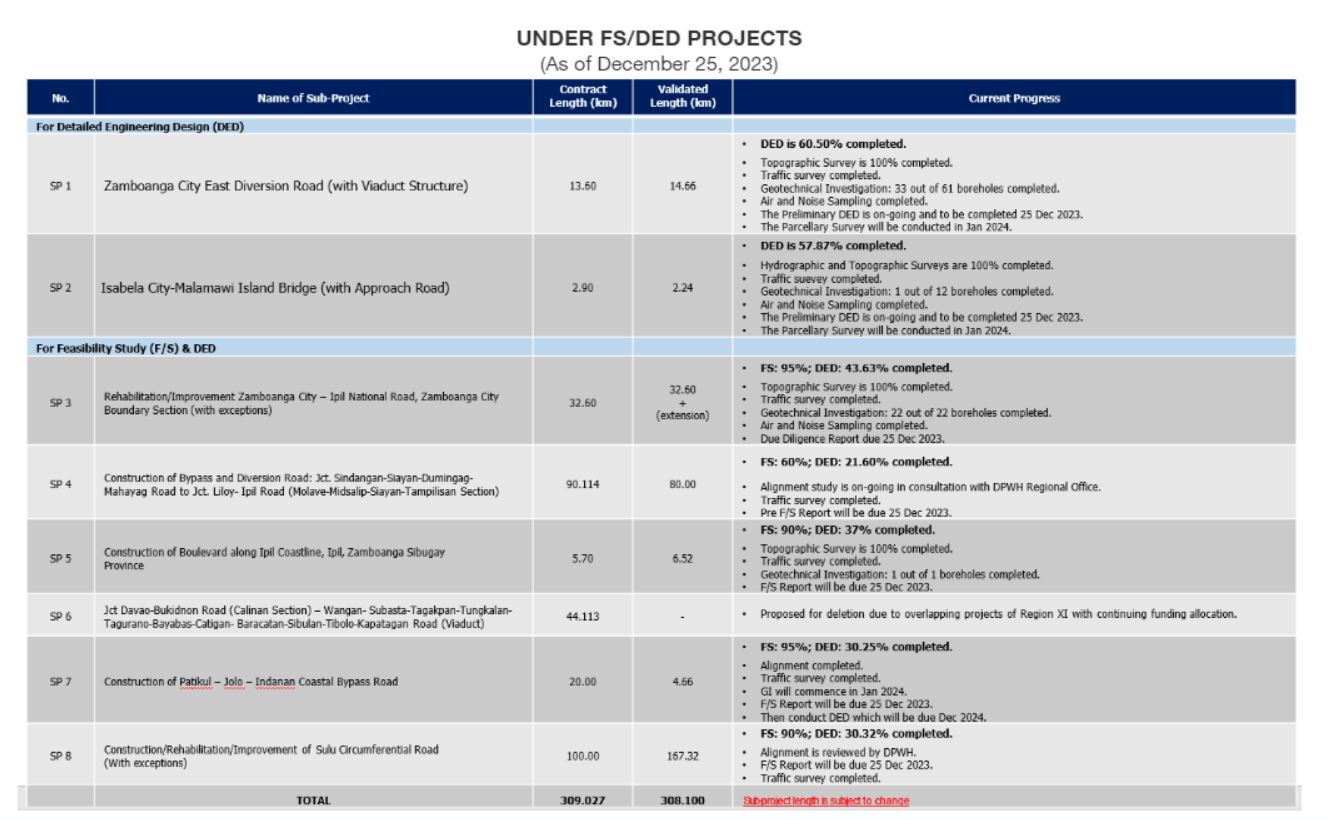

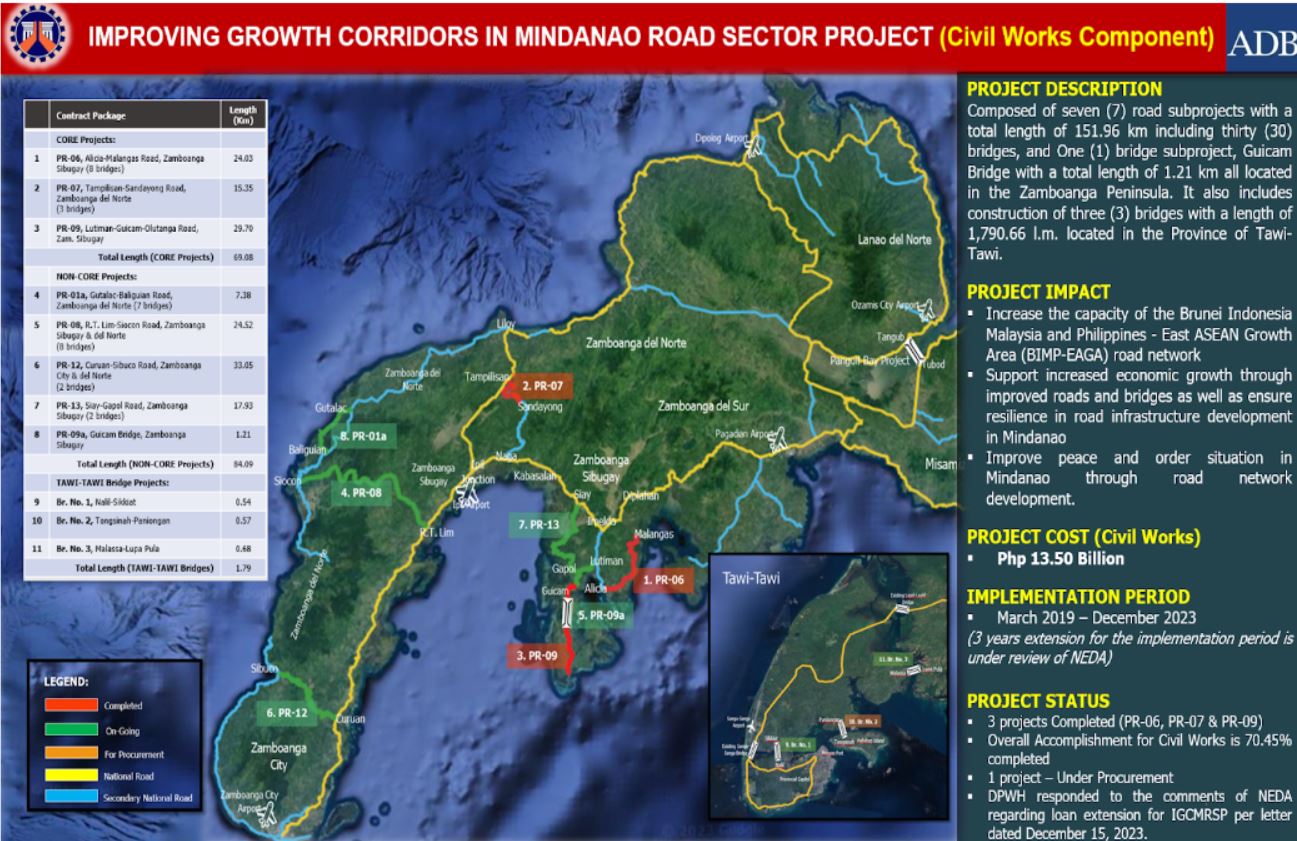

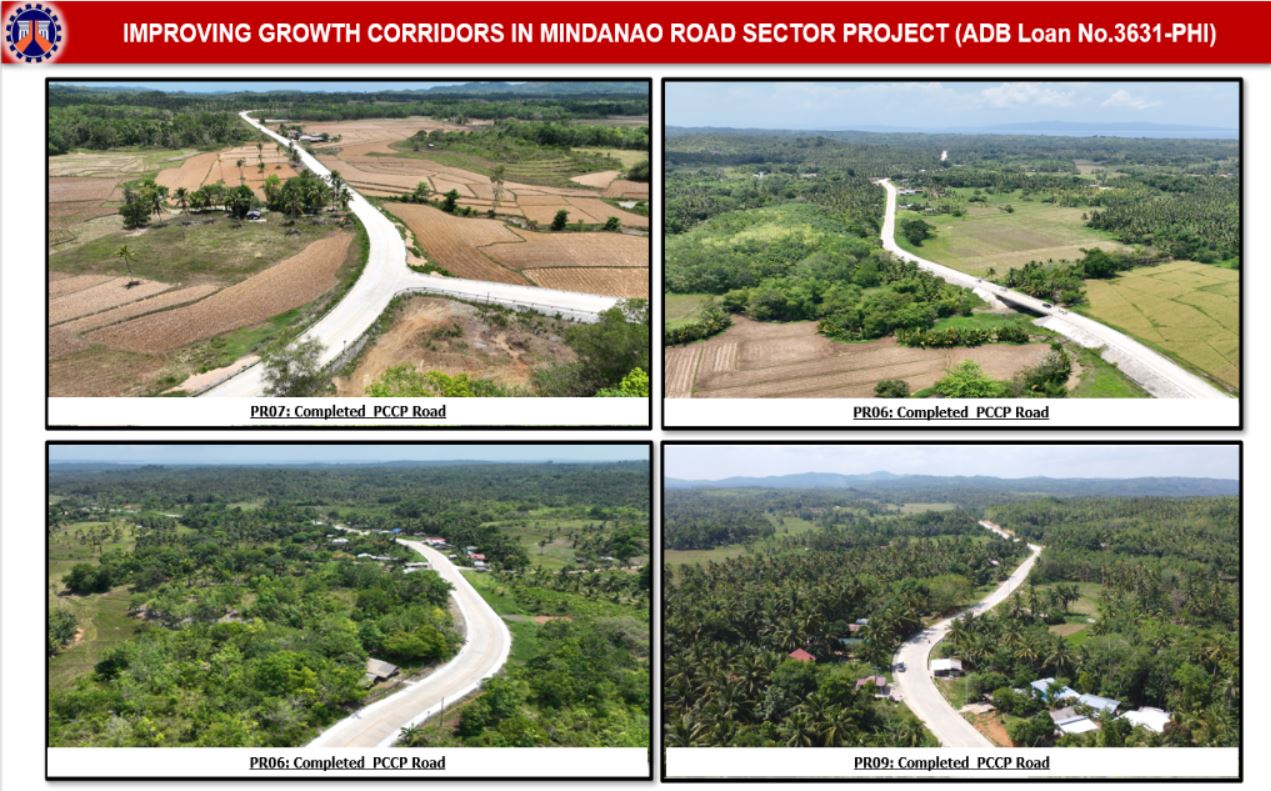

 TIMELINE   2018-2024
